TempleTXHomes Taylor Dasch · EG Realty Talk to Taylor
Chapter I — The Short Answer
AI Quick Answer

How will Temple TX’s data centers affect home prices?

The records reviewed for this page (City, County, state and company sources checked September 24–25, 2026) do not show that Temple’s data centers have raised or lowered home prices, and this page makes no price or rent forecast. Meta’s campus in Enterprise Industrial Park is operating. Rowan’s six buildings in Synergy Industrial Park are council-approved; two Project Temple buildings are under construction, and site grading was under way on the Stampede campus in late August 2026. For a specific Temple house, weigh its own evidence: the nearest project and its stage, the approved noise, lighting, buffer and traffic conditions for that land, recent comparable sales, and the home’s total monthly cost.

  • Operating: Meta Temple Data Center, which Meta said was serving traffic on July 22, 2026.
  • Under construction: two Rowan Project Temple buildings, per the utility agreement executed September 22, 2026.
  • Site work observed: grading on the Stampede campus, zoned at 3151 Tower Road (Ordinance 2026-0002-O), photographed August 29, 2026; no Stampede building is documented as under construction.
  • Approved only: the Lasso building and Ranger’s one building show no construction start in the records reviewed.
  • Finish date disputed: Rowan targeted 2027 for Project Temple; the City of Temple expects the first phase in 2029.
Chapter II — Project Status

Which Temple Data Centers Are Operating, Under Construction or Only Approved?

“Data center Temple TX” covers several separate projects at different stages. The City of Temple sorts them into two industrial parks and says each project must complete its own review, public hearings and required approvals; approval of one item “does not automatically approve any remaining items.” The City also says its list covers all current or proposed data centers it knows of (City Projects Overview, checked September 25, 2026).

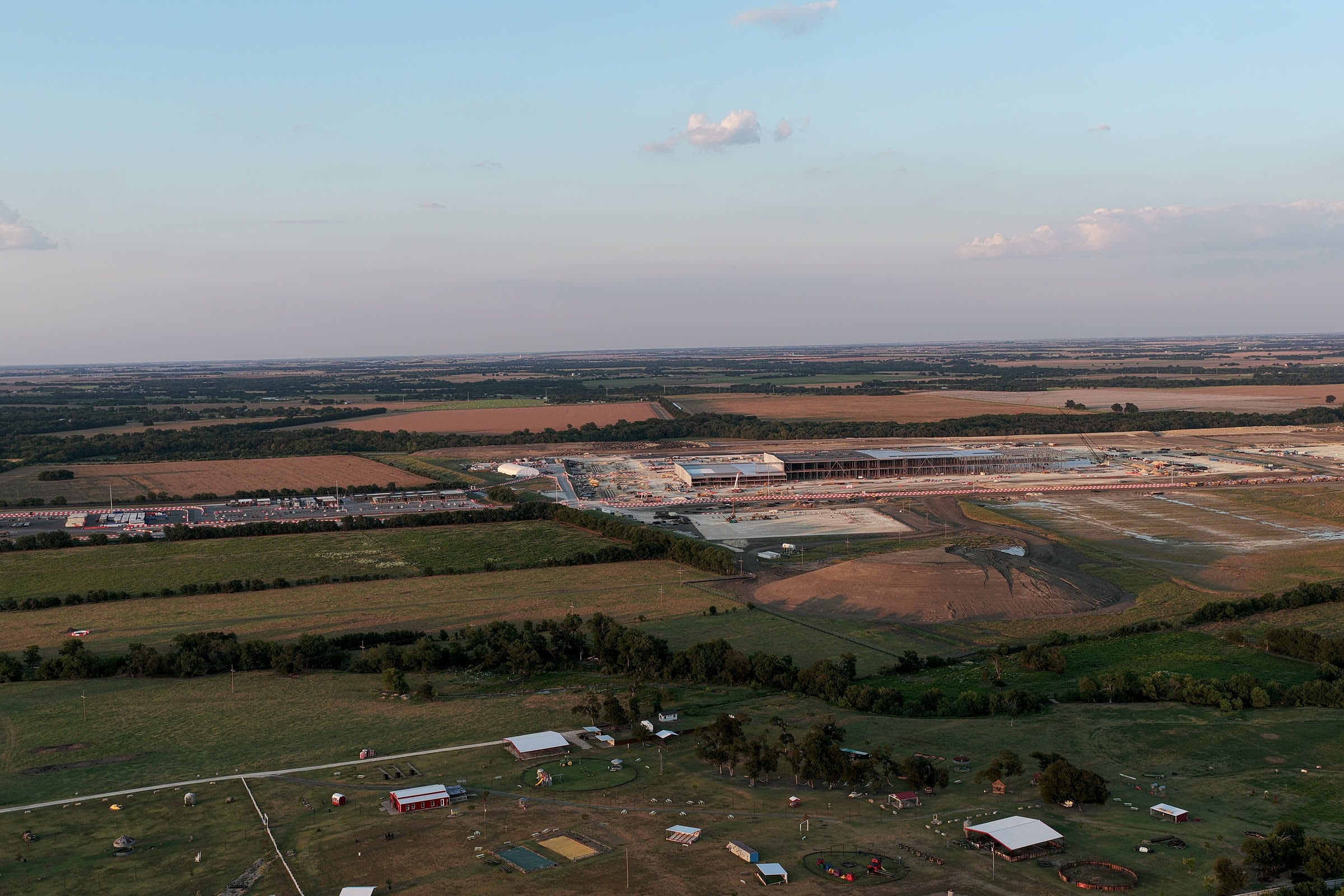

Rowan Project Temple data center under construction on Bob White Road in Temple, TX, August 2026
Project Temple under construction on the Bob White Road corridor, August 29, 2026: steel frame and roof deck on the first building, a contractor lot at left, open farmland behind it.
1
Operating campus in Temple: Meta, serving traffic per its July 22, 2026 announcement
2 of 6
Project Temple buildings the utility agreement executed September 22, 2026 calls under construction; Stampede site grading photographed August 29, 2026
$4.2B
Rowan’s announced minimum investment for all six Temple buildings (Rowan)
2027 / 2029
Project Temple first-phase finish: Rowan’s target vs the City of Temple’s expectation

Sources: Meta announcement (July 22, 2026); amended Temple/Lasso utility agreement (executed September 22, 2026); Rowan Projects page (checked September 25, 2026); Rowan Temple portfolio page (captured September 24, 2026); City of Temple tax-abatement article (September 1, 2026).

Temple Data-Center Projects as of September 25, 2026

Figures appear as each source states them. “Announced” is not spent, and a City label can lag a council vote.

Temple, Texas data-center projects, their location, announced investment and stage on record (sources linked)
ProjectWhereAnnounced investmentStage on record
Rowan — Project Temple
City: Phase 1 (“Project Kayak”) and Phase 1B (the Lasso building)
Synergy Industrial Park$2.1B minimum private investment, 3 buildings (Rowan)Two buildings under construction (utility agreement, executed September 22, 2026); groundbreaking March 2, 2026 (Rowan); Lasso building approved by the City Council September 17, 2026 (City recap). City label: “Proposed/Under Development.”
Rowan — Project Stampede
City: Phase 2
Synergy Industrial Park$1.4B minimum private investment, 2 buildings (Rowan)Rowan: “approved in Winter 2026”; utility agreement executed September 22, 2026; site work (grading) observed on the campus, zoned at 3151 Tower Road, in a first-party aerial photo of August 29, 2026; no building documented as under construction. City label: “Proposed.”
Rowan — Project Ranger
City: Phase 3
Synergy Industrial Park$700M minimum private investment, 1 building (Rowan)Rowan: “approved in Spring 2026”; utility agreement executed September 22, 2026; no construction start in the records reviewed. City label: “Proposed.”
Meta Temple Data Center
City lists it under Polmer
Enterprise Industrial ParkMore than $1.2B (Meta)Operating: Meta said on July 22, 2026 that it is “now serving traffic.” City: “completed and operational (2026).”
Oppidan — Connect Data CenterEnterprise Industrial Park; 2313 Eberhardt Road (TDLR)$31M estimated cost (TDLR registration)City: approved 2024. The TDLR registration (“5MW Temple Data Center”) lists an estimated completion date of October 16, 2026; a registration estimate is not a certificate of occupancy.
Rowan — Moriah (older building)Along Bob White Road (Rowan)Not statedOperational 2023; tenant left late 2024; Rowan plans to convert it to a warehouse (Rowan FAQ).

How to Read the Temple Data-Center Numbers

  • Rowan’s figures are announced minimums. Rowan’s Projects page, checked September 25, 2026, lists $2.1 billion for Project Temple’s three buildings, $1.4 billion for Stampede’s two and $700 million for Ranger’s one: “minimum private investment” of $4.2 billion for its six Temple buildings. That is not money spent or taxable value.
  • The City’s commitment uses a different unit. The City of Temple’s abatement requires at least $700 million of investment and 40 full-time jobs per abatement phase. Rowan’s older portfolio page called the Temple campus “a minimum $700 million investment”; the current Projects page says $2.1 billion for Project Temple. This page shows each figure with its source instead of reconciling them.
  • Operating and planned money stay separate. Meta’s “more than $1.2 billion” describes a campus that is running; Rowan’s $4.2 billion is a prospective minimum. Adding them would mix an operating facility with plans, so this page does not.
  • A tax registration is not a lease. The Texas Comptroller’s data-center list names Polmer LLC as the occupant of Rowan’s “Temple Data Center” (effective January 21, 2026) and “Stampede Data Center” (effective May 21, 2026), and the City pairs Polmer with Meta. The registry does not publish lease terms, which building will be used or an opening date, and Rowan’s FAQ says its customer is identified closer to completion.
Buyers Miss This
A built data center can lose its tenant. Rowan says its older Moriah building on Bob White Road became operational in 2023, its tenant left in late 2024, and Rowan plans to convert it to a warehouse for the teams at its nearby project. That history shows a project’s stage can move backward as well as forward; it is not a forecast for the newer projects or for home values.
Chapter III — Approval vs. Construction

What Do Temple’s Data-Center Approvals Cover, and What Is Built?

Annexation and zoning, a development agreement, a tax abatement, a utility agreement, a building permit, construction and occupancy are separate steps. The City of Temple’s September 17 council recap, published September 18, 2026, documents approvals; it does not certify finished construction, every building permit, occupancy or an opening date.

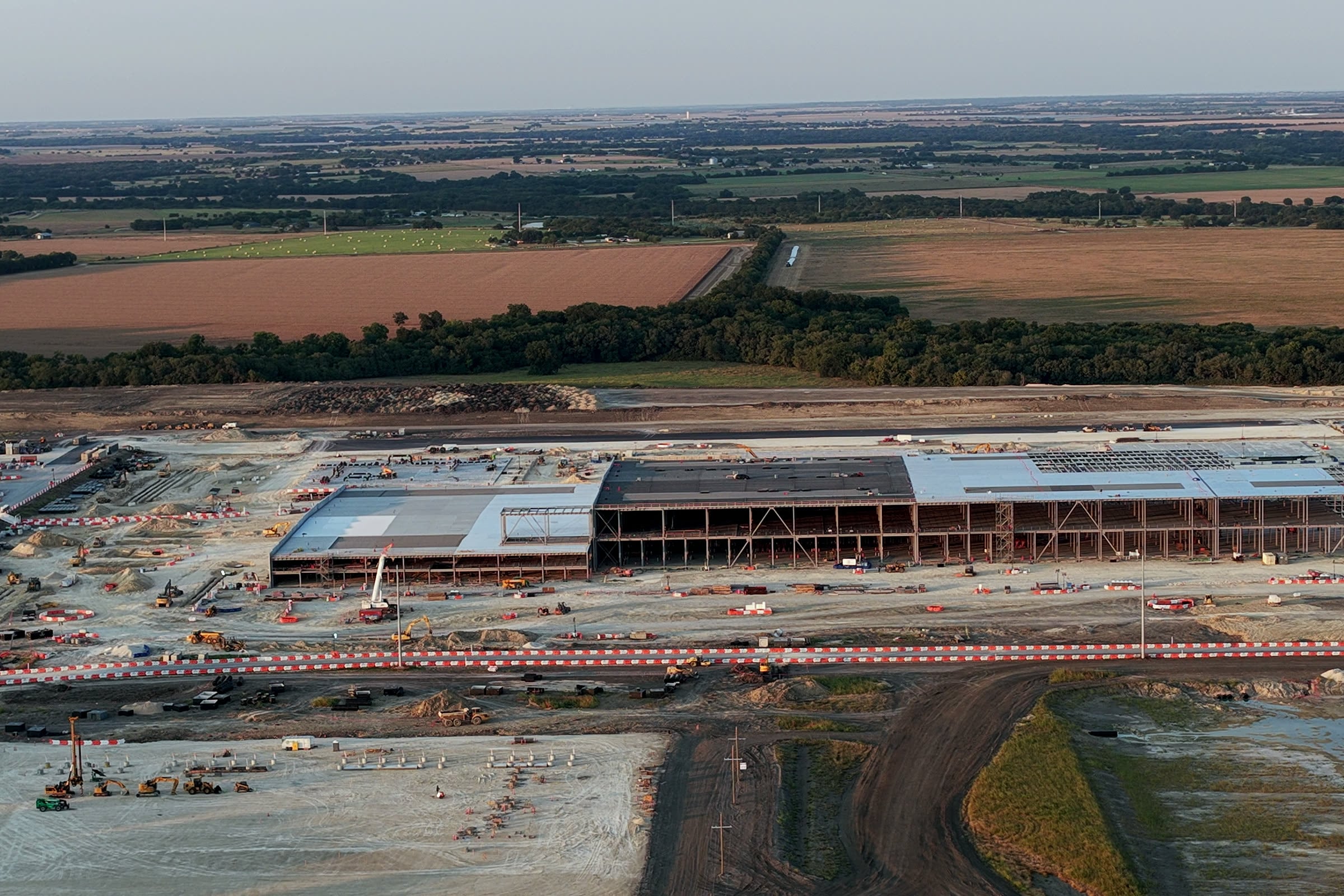

Structural steel and roof deck going up at the Rowan Project Temple data center site on Bob White Road, Temple, TX
Structural steel and roof deck on Project Temple’s first building, with poured pier caps in the foreground, August 29, 2026.
September 18, 2025
Project Temple land annexed and zoned
The City Council gave final approval to annexing the land addressed as 1707 and 2351 Bob White Road (Ordinance 2025-0038) and to its Planned Development–Light Industrial zoning (Ordinance 2025-0039-O).
October 2, 2025
City tax abatement approved
Resolution 2025-0333 approved a Chapter 312 abatement agreement: 50% of the City’s incremental real-property taxes on the project’s land and improvements, and 50% of City taxes on its personal property, for 10 calendar years per phase, tied to at least $700 million of investment and 40 full-time jobs per phase.
October 14, 2025
Bell County authorizes a separate abatement
The Commissioners Court unanimously authorized a tax-abatement agreement with Rowan Temple LLC for certain Synergy Park property (Minute Order 303/25). The order does not state the County’s percentage or term.
November 20, 2025
Development agreements; City signs the abatement
The Council approved development agreements for Project Temple and Project Stampede (minutes). The City signed the abatement agreement the same day; Rowan had signed on November 11.
Late 2025 to March 2, 2026
Construction starts; public groundbreaking
Rowan’s portfolio page says construction started in late 2025. Rowan celebrated the public groundbreaking of Project Temple on March 2, 2026.
April 16, 2026
Ranger development agreement
The Council approved the development agreement for Project Ranger (minutes).
July 22, 2026
Meta’s separate campus comes online
Meta announced that its Temple Data Center, in Enterprise Industrial Park, is serving traffic.
September 17, 2026
Lasso building and utility terms approved
Per the City’s recap: annexation, zoning and a development agreement for the Lasso building; an infrastructure agreement covering all three Rowan phases, under which Rowan will fund $38,545,796 for infrastructure projects; a utility service agreement for each phase; and an abatement amendment. Rowan’s Projects page, checked September 25, 2026, still called the Lasso hearings upcoming.
September 22, 2026
Utility agreements executed
The amended Project Temple agreement refers to “the two buildings under construction on the Land.”
October 31, 2026
First scheduled water tranche
About 2 million gallons of charging water and 4,000 gallons a day of domestic water for those two buildings, subject to the agreement’s conditions.
2027, 2029 or FY 2031
Completion estimates differ
Rowan’s portfolio page targeted 2027 (captured September 24, 2026). The City of Temple expects the first phase in 2029 and estimates full buildout of all three phases in fiscal year 2031 (City article, September 1, 2026).

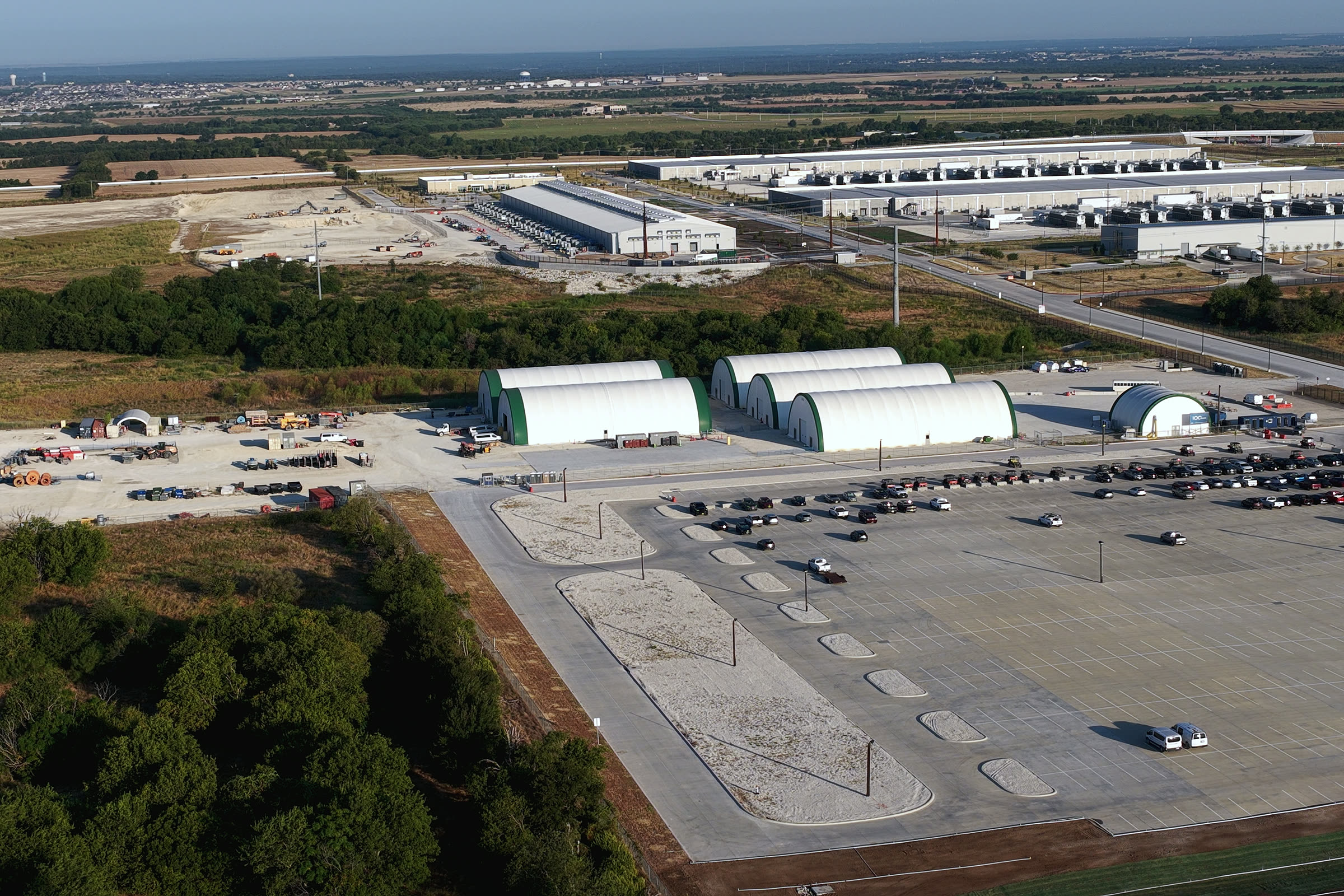

Contractor parking and temporary construction buildings at the Meta data center campus in Temple, TX
Contractor parking and temporary fabric warehouses beside the Meta campus buildings on August 29, 2026, about five weeks after Meta announced the campus was serving traffic.
Next Dates on the Record (as of September 25, 2026)
  • October 16, 2026: Oppidan’s estimated completion date on its TDLR registration.
  • October 31, 2026: first scheduled water tranche for Project Temple’s two buildings under construction.
  • Not yet in the records reviewed: the City’s official minutes, with vote counts, for the September 17, 2026 council meeting.
  • 2027 (Rowan) or 2029 (City): Project Temple first-phase completion; the City estimates full buildout in fiscal year 2031.
What the Tax Breaks Do, and Do Not Do

The City of Temple’s explainer says an abatement “temporarily reduces a portion of a company’s property taxes”; the rest is still paid (City article, September 1, 2026). Bell County’s order authorizes abating “a percentage” of the increase in taxable value of certain Synergy Park property without stating the percentage or term, so this page does not assume the City’s terms apply to the County.

Neither agreement sets a homeowner’s bill. A Temple home’s taxes still depend on its appraised value, its exemptions and the rates each taxing unit adopts; the Temple property-tax guide walks through an address-level estimate.

Chapter IV — Locations

Where Are Temple’s Data Centers Located?

The City of Temple sorts the projects into two industrial parks. Its Industrial Park Development Areas map labels Enterprise Park “North Industrial” and Synergy Park “South Industrial.” Meta and Oppidan are in Enterprise Industrial Park; every Rowan phase is in Synergy Industrial Park. Rowan describes its sites as industrial land in east Temple.

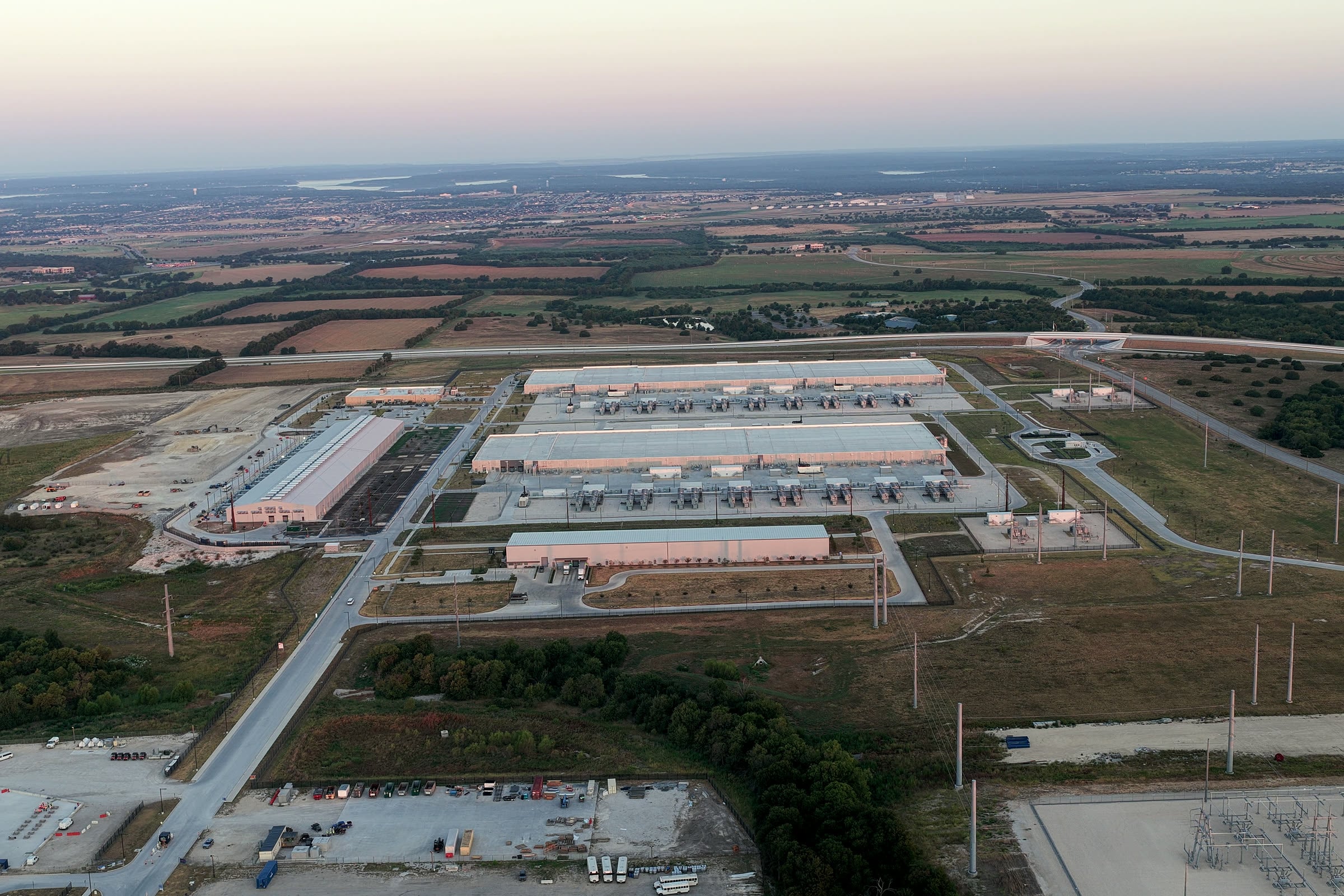

Aerial view of the Meta data center campus and an electrical substation in Enterprise Industrial Park, Temple, TX
The Meta data center campus at dawn on August 29, 2026, from about 600 feet, with an electrical substation at bottom right.

Official Location Descriptions for Temple’s Data Centers

  • Rowan Project Temple (City Phase 1A): the 2025 annexation ordinance addresses the land as 1707 and 2351 Bob White Road (Ordinance 2025-0038). The City’s Rowan Projects Map shows it east of Bob White Road and south of Tower Road.
  • Lasso building (City Phase 1B): “generally located northwest of FM 3117 and east of Bob White Road” (City staff presentation, September 3, 2026).
  • Rowan Project Stampede (City Phase 2): “adjacent to and north of the intersection of Southeast H.K. Dodgen Loop and the Burlington Northern Santa Fe rail line” (Ordinance 2026-0016-O, Tax Abatement Reinvestment Zone No. 49).
  • Rowan Project Ranger (City Phase 3): “east of Highway 190 and both north and south of FM 3117” (City notice for Tax Abatement Reinvestment Zone No. 50).
  • Meta Temple Data Center: Enterprise Industrial Park (City project list). The sources reviewed do not give a street address.
  • Oppidan Connect Data Center: 2313 Eberhardt Road (TDLR registration), Enterprise Industrial Park (City).
  • Rowan Moriah: along Bob White Road (Rowan FAQ).

Acreage is left out on purpose: the annexation, zoning, reinvestment-zone and utility documents each describe a different legal boundary, so their acreage figures are not interchangeable. For parcel lines, use the City’s own maps on its Projects Overview page (tabs “Rowan Projects Map” and “Industrial Park Development Areas,” captured for this page September 25, 2026).

Little Gem
The landfill is a neighbor too. The City’s Rowan Projects Map also shows the City landfill and a planned landfill expansion area along Tower Road, beside Project Temple. The City says the Lasso site replaces part of the original Project Temple land after Rowan assigned its purchase contract for land needed for that expansion. If you are looking near Tower Road or Bob White Road, check both uses.

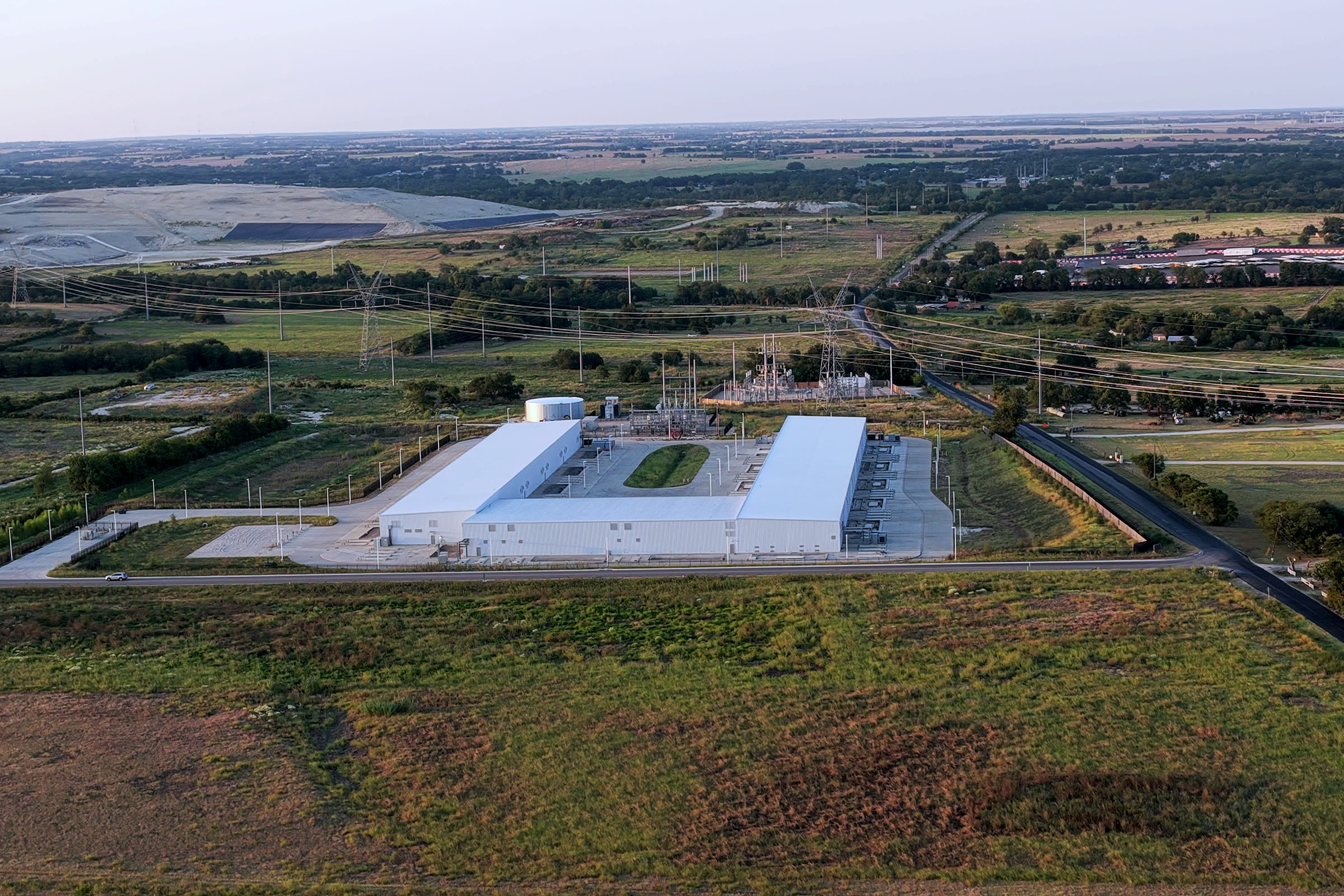

Aerial view of a data center building, an electrical substation and transmission lines near Bob White Road, Temple, TX
A data-center building, an electrical substation and converging transmission lines along the Bob White Road corridor, August 29, 2026. The facility’s owner and operating status are not identified here.
Chapter V — Water

How Much Water Will Rowan’s Temple Data Centers Use?

Two different numbers get mixed up: the one-time initial charge that fills a closed cooling loop, and the routine domestic water the buildings use each day. The utility agreements executed September 22, 2026 set both for each Rowan phase in Temple.

Closed-loop coolingWhat the agreements say
Initial charge vs. daily use

“Closed loop” describes the cooling water, not every gallon on site. The loop is filled once and reused; the buildings still use ordinary domestic water every day.

The sealed circuit · general mechanism
ServersRacks generate heat. The coolant picks it up.
Heat rejectionRowan says its data centers use air-cooled heat-rejection systems.
← cooled coolant returns to the racks · the same charge, reused

The City of Temple says a closed-loop system does not require daily make-up water because evaporation does not occur within the system.

On the record
What the City and Rowan say

City of Temple FAQ: a closed-loop cooling system “does not require ‘make-up’ or recharge water on a daily basis because evaporation does not occur within the system.” Rowan FAQ: the system is “designed to withstand extreme temperatures, including Texas heat waves, without additional water.”

Water used: an initial charge, plus daily domestic water
Not established
Independent verification

The records reviewed for this page include no independent test of how the cooling performs in extreme heat, and they do not identify Project Temple’s specific heat-rejection equipment. Rowan’s statement is a design claim.

Status: not independently verified
4.5M gal
Project Temple’s initial charge for three buildings (1,500,000 gallons each) under the amended agreement executed September 22, 2026; expected to last about 10 years
13,800 gal/day
Project Temple’s average domestic demand (peak 33,600). From October 31, 2026 the first tranche is 4,000 gal/day plus about 2 million gallons of charging water
18M gal/day
City of Temple’s average daily treated-water demand, for scale (City FAQ, captured September 24, 2026)
What the documents say
✓In the executed agreements (September 22, 2026). Project Temple: about 4.5 million gallons of initial charge for three buildings (agreement). Stampede and Ranger: 3 million gallons each (Stampede, Ranger). Average domestic demand: 13,800, 8,200 and 10,100 gallons a day.
●Dated FAQs lag. The City’s protections FAQ and Rowan’s FAQ still describe the first phase’s earlier terms, about 2 million gallons and 4,000 gallons a day. When sources disagree, the executed agreement is the controlling document.
✗Not verified. Independent performance data for the cooling systems in extreme heat.

The loop diagram shows how closed-loop cooling works in general; it is not an engineering drawing of Project Temple. Gallon figures: executed utility agreements (September 22, 2026) and the City of Temple’s protections FAQ (captured September 24, 2026).

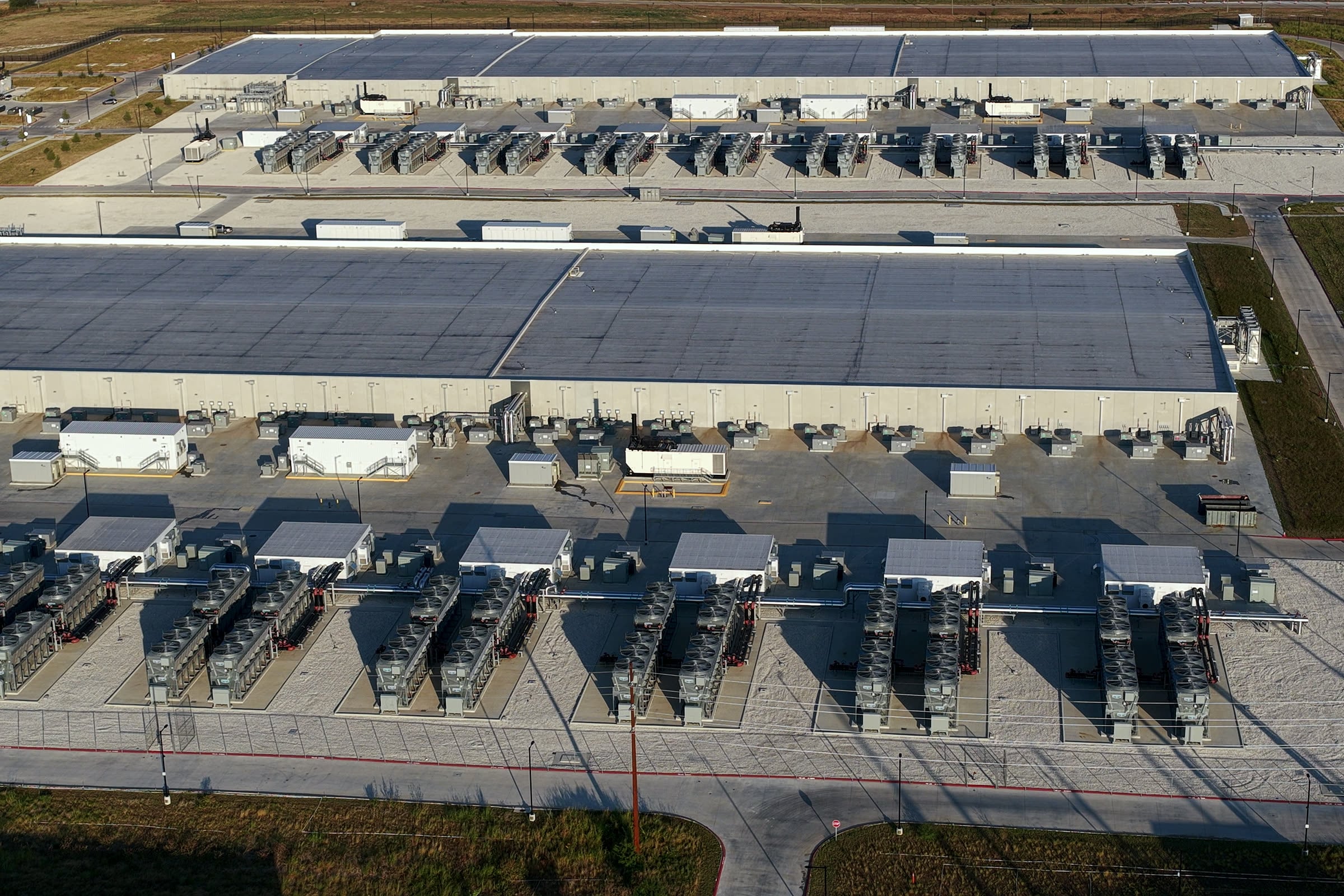

Cooling arrays and equipment rows on the Meta data center campus, Enterprise Industrial Park, Temple, TX
Cooling arrays and equipment rows on the Meta data center campus, photographed August 29, 2026.
Recharges Are Allowed, Not Unlimited

The Project Temple agreement expects the initial charge to last about 10 years but acknowledges more water may be needed. The City will allow additional charges at its “sole reasonable discretion,” considering weather and peak demand, and agrees they “will not be unreasonably withheld, conditioned, or delayed.” The City’s FAQ adds that the developments are water customers subject to its drought contingency plan, and its September 18 recap estimates that at full buildout all three phases together will use less than 1% of the water City customers use each day. For scale, the entire 4.5-million-gallon charge equals about one quarter of one day of the City’s average treated-water demand (4.5 million ÷ 18 million).

Chapter VI — The Address Checklist

How Do You Check a Specific House Near a Temple Data Center?

Use these seven steps before an offer on any house near Enterprise or Synergy Industrial Park. Each names the record to ask for; none requires guessing what a data center will do to prices.

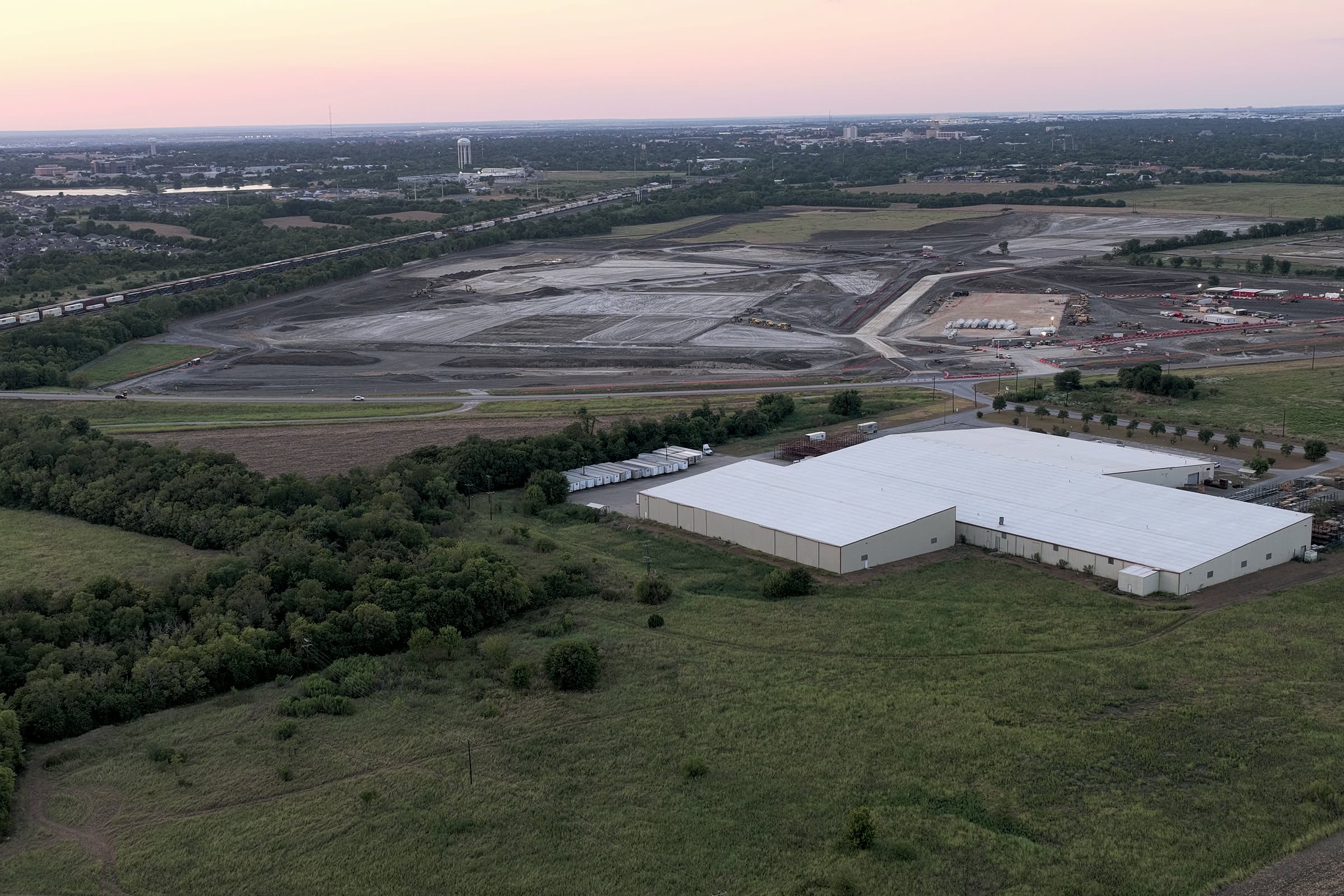

Several hundred acres under grading in southeast Temple, TX, rail-served, with the Temple skyline on the horizon
Site work on Rowan’s approved Project Stampede campus: several hundred acres under active grading off Tower Road in southeast Temple on August 29, 2026, rail-served, with a freight train at left and downtown Temple on the horizon. No building is documented as under construction here.
Step 1
Find the nearest project and its stage
Record: City project list and maps

Match the address to the City’s Rowan Projects Map or Industrial Park map, then check the project’s stage in the table above: operating, under construction or approved only. A listing that mentions “the data center” should say which project and which milestone.

Step 2
Read the zoning next door
Record: zoning ordinance and development agreement

Rowan’s phases are zoned Planned Development–Light Industrial with project-specific conditions. The City says approved projects carry enforceable conditions for noise, lighting, landscaping, buffering, traffic and site design. Under code changes adopted September 17, 2026, future data centers need a Conditional Use Permit to develop in light- or heavy-industrial districts, so check the zoning of any vacant industrial land near the house.

Step 3
Ask for the noise documents
Record: Noise Mitigation Plan and acoustical report

Before a building permit, the City requires a Noise Mitigation Plan by a qualified acoustical engineer that evaluates predicted sound levels at property lines; before occupancy, a post-construction acoustical report. These show the approved plan, not the sound at a particular house.

Step 4
Check lighting and construction traffic
Record: traffic study and lighting plans

The City requires a preliminary traffic study, covering construction and operational traffic, before plat approval. Rowan says photometric (lighting) plans will be submitted to the City and that designated construction routes are among its mitigation tools. Ask which roads near the house carry construction trucks.

Step 5
Ask about temporary power
Record: Rowan FAQ and the abatement amendment

Rowan says it plans a temporary natural-gas power solution for a portion of the campus until permanent utility service is available. The City’s September 2026 abatement amendment discontinues abatement benefits for any period temporary generation runs beyond the allowable period. Near Project Temple, ask where temporary generation would sit.

Step 6
Visit at your own hours
Record: your own visit

Go at the times you would normally be home, such as evenings, nights and weekends, and once during weekday construction hours. Listen and look from the house and from the nearest project boundary.

Step 7
Price the house on its own evidence
Record: comparable sales, inspection, tax and insurance quotes

Use recent comparable sales for that home type and location, the inspection, property-tax and insurance estimates, any HOA dues, and your own budget and timeline. Do not add a premium for a nearby project or count on rent from construction crews.

Where to Get the Records for a Temple Address

To price the house itself, the Temple homebuyer guide covers budgets and search steps, and the property-tax guide covers the tax line.

Chapter VII — For Buyers

What Should Temple Home Buyers Do About the Data Centers?

Treat a nearby data center as a property-specific factor to check, not as a price signal in either direction.

Aerial view across Temple TX farmland and a new subdivision toward Interstate 35 and the Temple skyline
Open ground, a finished subdivision, then I-35 and Temple on the horizon, August 29, 2026. Land between a house and an industrial park can change, so check its zoning.

If a Temple Listing Mentions the Data Centers

Ask which project it means, which milestone is documented (approved, under construction or operating) and the source. A nearby project’s announced investment is not evidence of that house’s value; the house’s own comparable sales are.

If You Are Choosing Between Similar Temple Houses

Compare them on recent comparable sales, condition, inspection findings and total monthly cost, then run the checklist for each. The records reviewed here do not support paying more, or asking for less, because of distance to a data center alone.

If the House Backs Onto Open or Industrial Land

Check the zoning and any approved conditions for that land, and plan for the view to change. Rowan’s phases already have Planned Development–Light Industrial zoning; under the September 17, 2026 code changes, a future data center elsewhere would need a Conditional Use Permit in light- or heavy-industrial districts.

Taylor Dasch, Temple TX real estate agent
Who Prepared This Guide
Taylor Dasch
EG Realty | Real Estate Agent | $20M+ / 85+ real estate transactions

Taylor Dasch, a real estate agent with EG Realty in Temple, prepared this guide from the public records listed under Sources and Dates and from first-party aerial photographs of the project areas taken August 29, 2026.

It is a research guide for buyers, not a forecast: it does not predict prices, rents or completion dates, and it does not measure noise at any house.

For help applying the checklist to a specific address, use the form at the end of this page or call 254-718-4249. Taylor replies personally; there is no automated report.

Taylor Dasch | EG Realty | 254-718-4249 | dealswithdasch@gmail.com
Chapter VIII — Questions Answered

New to Temple? Start with Living in Temple TX (cost, neighborhoods, pros and cons), then the neighborhood directory.

Temple TX Data Centers: Frequently Asked Questions

Will the data centers raise home prices in Temple, TX?

The records reviewed for this page, checked September 24–25, 2026, do not show that Temple’s data centers have raised or lowered home prices, and this page does not forecast either. For a specific house, rely on its recent comparable sales, condition, total monthly cost and the approved conditions for nearby land rather than on a project’s announced investment.

Which Temple data centers are operating now?

Meta’s Temple Data Center is operating: Meta announced on July 22, 2026 that it was serving traffic, and the City of Temple lists it as completed and operational. Rowan’s six planned buildings are council-approved, and the utility agreement executed September 22, 2026 refers to two Project Temple buildings as under construction. Site grading was under way on Rowan’s Stampede campus, zoned at 3151 Tower Road, in a first-party aerial photo of August 29, 2026; no Stampede building is documented as under construction. Rowan says the tenant of its older Moriah building left in late 2024 and that it plans to convert that building to a warehouse.

Where are the data centers in Temple, TX?

The City of Temple places them in two industrial parks. Meta’s campus and Oppidan’s smaller project, registered at 2313 Eberhardt Road, are in Enterprise Industrial Park, which the City’s map labels North Industrial. All of Rowan’s phases are in Synergy Industrial Park, labeled South Industrial; the 2025 annexation ordinance for Project Temple lists 1707 and 2351 Bob White Road.

When will Rowan’s Temple data center be finished?

Sources disagree. Rowan’s portfolio page, captured September 24, 2026, targeted substantial completion in 2027. The City of Temple said on September 1, 2026 that the first phase is expected to be completed in 2029, and it estimated full buildout of all three Rowan phases in fiscal year 2031. None of these is a guaranteed opening date.

How much water will Rowan’s Temple data centers use?

Under the agreement executed September 22, 2026, Project Temple’s closed-loop cooling takes an initial charge of about 4.5 million gallons for three buildings, expected to last about 10 years, plus an average of 13,800 gallons a day of domestic water (peak 33,600). Stampede and Ranger each have a 3-million-gallon initial charge and average domestic demands of 8,200 and 10,100 gallons a day. Additional charges need the City’s consent.

What tax breaks did Temple and Bell County approve for Rowan?

The City of Temple approved a Chapter 312 abatement on October 2, 2025: 50% of the City’s taxes on the project’s new real and personal property value for 10 calendar years per phase, tied to at least $700 million of investment and 40 full-time jobs per phase. Bell County’s Commissioners Court unanimously authorized a separate abatement agreement with Rowan Temple LLC on October 14, 2025 (Minute Order 303/25); the order does not state the County’s percentage or term.

Is Meta the tenant of Rowan’s Temple data center?

That is not confirmed. The Texas Comptroller’s data-center list names Polmer LLC, which the City of Temple pairs with Meta, as the occupant of Rowan’s Temple and Stampede registrations. That is a tax-registration role, not a published lease, and Rowan says it identifies its customer closer to completion.

How can I check noise near a house by a Temple data center?

Ask the City of Temple for the project’s Noise Mitigation Plan, which must be prepared by a qualified acoustical engineer and evaluate predicted sound levels at property lines before a building permit, and for the post-construction acoustical report required before occupancy. Those show the approved plan, not the sound at a particular house, so also visit at the hours you would normally be home.

Chapter IX — Sources

Sources and Dates for This Temple Data-Center Guide

Each source below was read for this page; the date shows when it was checked. Where sources disagree (completion dates, investment presentations, first-phase water terms), the page shows both with their dates instead of choosing one.

Not covered: MLS price analysis, noise or light measurements, parcel surveys, and any forecast of prices, rents or completion dates. The City’s official minutes for the September 17, 2026 meeting were not among the records reviewed.

Want Help Checking a Temple Address Near a Data Center?

Send the address you are considering. Taylor will reply personally with what the public record shows for the nearest project, which documents to request and what to verify before an offer. It is a manual reply, not an automated report.

Taylor Dasch
Taylor Dasch
EG Realty | Temple, TX
254-718-4249 | dealswithdasch@gmail.com

Explore More Temple TX Resources

Checking a Temple address near a data center?

Leave your details and Taylor will follow up personally to get the address, then walk through what the public record shows for it: the nearest project and its stage, the approved conditions to request, and what to check before an offer. A manual reply, not an automated report or PDF. Taylor Dasch, real estate agent at EG Realty in Temple, Texas.

No spam, no auto-dialer — you’ll hear from Taylor directly. Prefer to talk? Call/text 254-718-4249 or book a 15-min call.

Taylor Dasch · REALTOR® · Texas Real Estate License #0775435

EG Realty

Texas Real Estate Commission Information About Brokerage Services · Texas Real Estate Commission Consumer Protection Notice

Equal Housing Opportunity. Housing is offered without regard to race, color, religion, sex, handicap, familial status, or national origin. Information is deemed reliable but not guaranteed and is subject to change.
